Project Mobilization Date: July 20, 2026 Work Start Date: May 4, 2026 (for emergency repairs) Expected completion: February 2027 (new, was December 2026) Primary contractor: Prostar https://prostar.ca/
Weather: 27°C, sunny Workers onsite: At least five
Work done today:

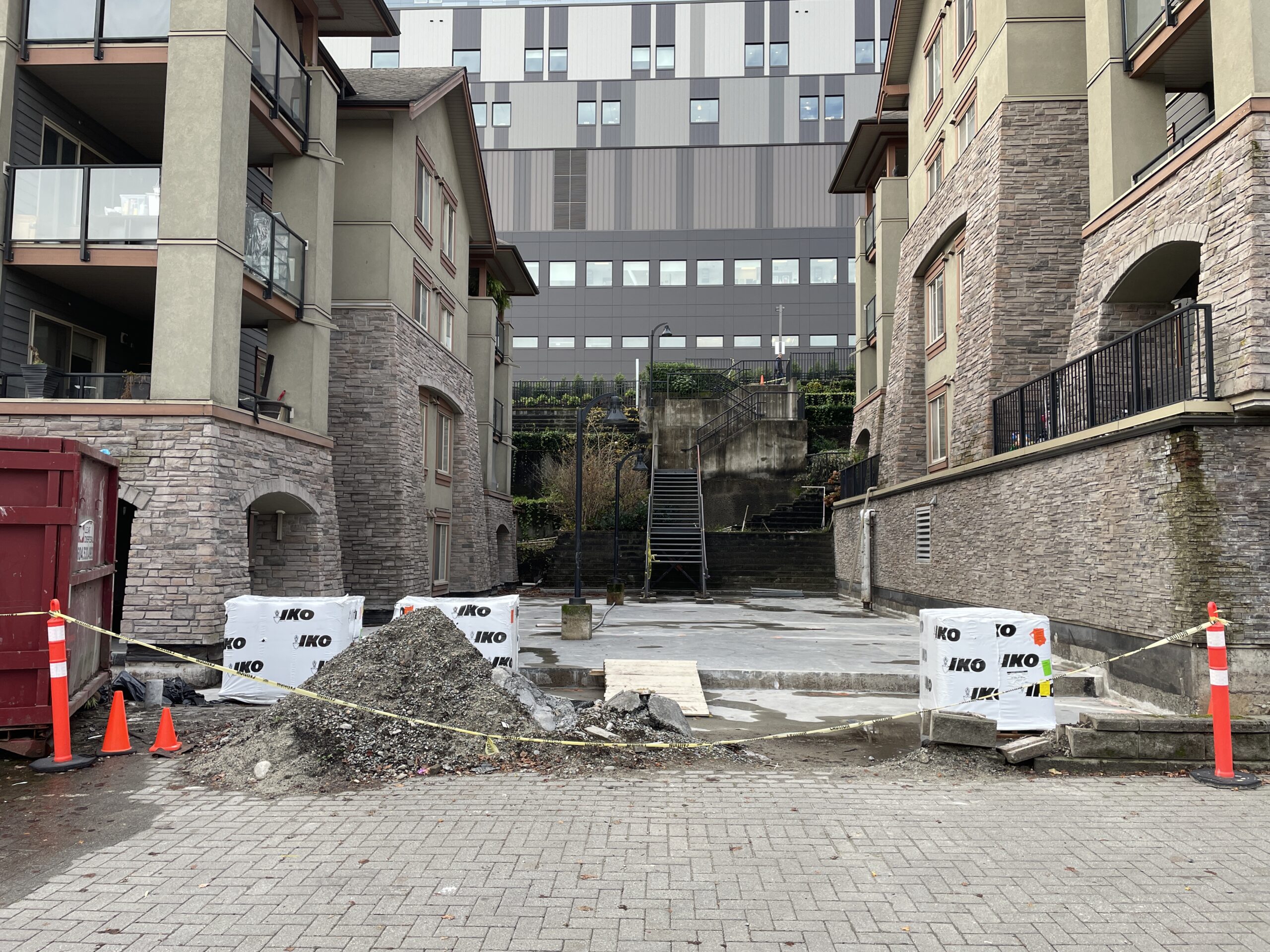

Stripping of membrane and polishing of concrete slab in area of visitor parking in front of Building 244 began

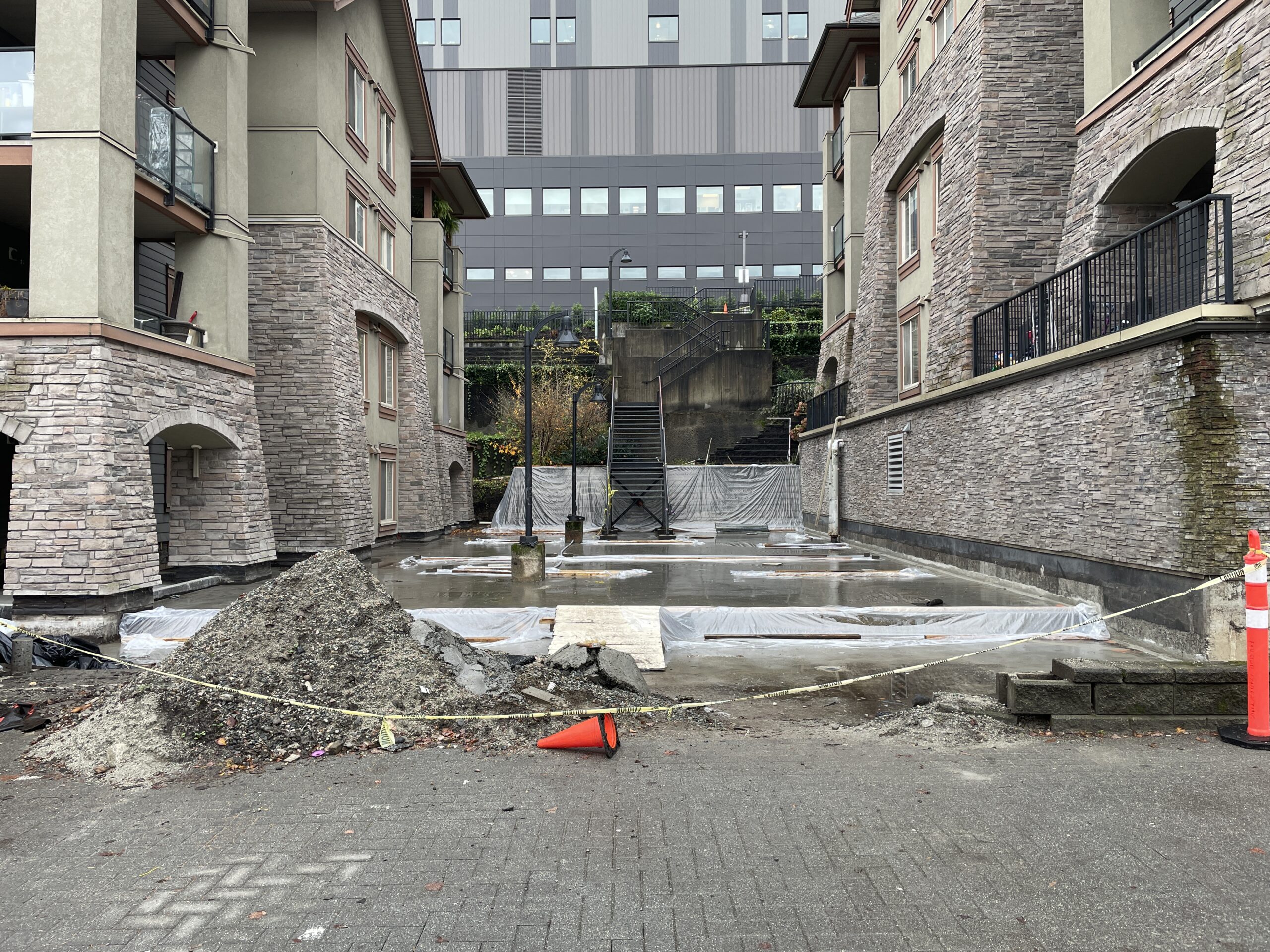

Area is now being stripped of old membrane and concrete slab polished.Same area but viewed looking to the west.
Project Mobilization Date: July 20, 2026 Work Start Date: May 4, 2026 (for emergency repairs) Expected completion: February 2027 (new, was December 2026) Primary contractor: Prostar https://prostar.ca/
Weather: 26°C, mostly sunny Workers onsite: At least five
Work done today:
Completion of removal of pavers in area of parking lot adjacent to 244 building
Removal of sand from the same area (new sand is used due to contamination and other issues with existing sand)
Are stripped of pavers and most sand. Water is from a shower that passed over shortly before the shot was taken.Similar shot, but looking to the west.
NOTE: The workers were here well past their usual time. I don't have insider information, but I believe what happened is they needed to have the (very large) amount of sand removed tonight so they could begin stripping the old membrane tomorrow and the dump truck arrived late for reasons unknown.
Project Mobilization Date: July 20, 2026 Work Start Date: May 4, 2026 (for emergency repairs) Expected completion: February 2027 (new, was December 2026) Primary contractor: Prostar https://prostar.ca/
Weather: 33°C, sunny Workers onsite: At least five
Work done today:
Two of the four Building 244 patios have had membrane applied
More pavers have been removed from the parking lot adjacent to Building 244
Current extent of paver removal next to the 244 building.Membrane applied to two of the four patios.More pavers being stacked on a plywood sheet over the new membrane and aeration mat.
Project Mobilization Date: July 20, 2026 Work Start Date: May 4, 2026 (for emergency repairs) Expected completion: February 2027 (new, was December 2026) Primary contractor: Prostar https://prostar.ca/
Weather: 33°C, sunny Workers onsite: At least four
Work done today:
Additional work on the Building 244 patios facing the visitor parking
A section of pavers was removed from the parking lot in front of the patios
Plywood planking was removed from the temporary ramp that had been installed at the Building 244 entrance
Wide nagle shot showing pavers removed from parking lot.Two of the four patios being worked on in the 244 building.Plywood planking removed from Building 244 entrance ramp.Pavers stacked onto a single sheet of plywood on new (unprotected) membrane in unfinished Phase 1 area. 🤔
Project Mobilization Date: July 20, 2026 Work Start Date: May 4, 2026 (for emergency repairs) Expected completion: February 2027 (new, was December 2026) Primary contractor: Prostar https://prostar.ca/
Weather: 31°C, mostly sunny Workers onsite: 6–8, varying at times
Work done today:
Entire south side of visitor parking lot fenced off
Pavers removed from south sidewalk adjacent to Building 244
Start of demolition of four patios in Building 244 for membrane replacement

Allan blocks removed from remaining planter outside Building 244
Two down spouts fitted to Building 240 in the emergency repair area
A few observations:
The majority of the closed-off parking area is not being used and the loop around is again cut off. This severely restricts the number of parking spaces and may hinder access by emergency vehicles.
I have already observed people parking in any free space.
No work in the Phase 1 extension or emergency repair area (except the down spouts being attached as noted above). Unclear when these areas will be done, with the project now expanding into Stage 3.
The City of New Westminster permits on the C can.No vehicle access to south part of visitor parking.Allan blocks and sidewalk pavers removed from Building 244. Tree picxtured will be relocated if possible.Stripped patios on left, pavers removed from sidewalk, Allan blocks removed, Building 244.
Project Mobilization Date: July 20, 2026 Work Start Date: May 4, 2026 (for emergency repairs) Expected completion: February 2027 (new, was December 2026) Primary contractor: Prostar https://prostar.ca/
The City of New Westminster has finally granted the permit and today is the day when Phase 2 of the membrane replacement project officially gets underway.
I am not aware of any explanation from Prostar or Strata Engineering on why no work was done over the past week in either the Phase 1 extension area or the emergency repair area.
The notice provided to owners by Prostar outlining “Stage 3” is below.
