Phase 1 Membrane Project, Day 66 (November 18, 2025)

Phase 1 Membrane Replacement Project

Project Mobilization Date: August 11, 2025
Work Start Date: August 28, 2025
Expected duration: 2–3 months (Completion now expected in January 2026)
Primary contractor: Prostar https://prostar.ca/

Weather: 9C, cloudy

Work done today:

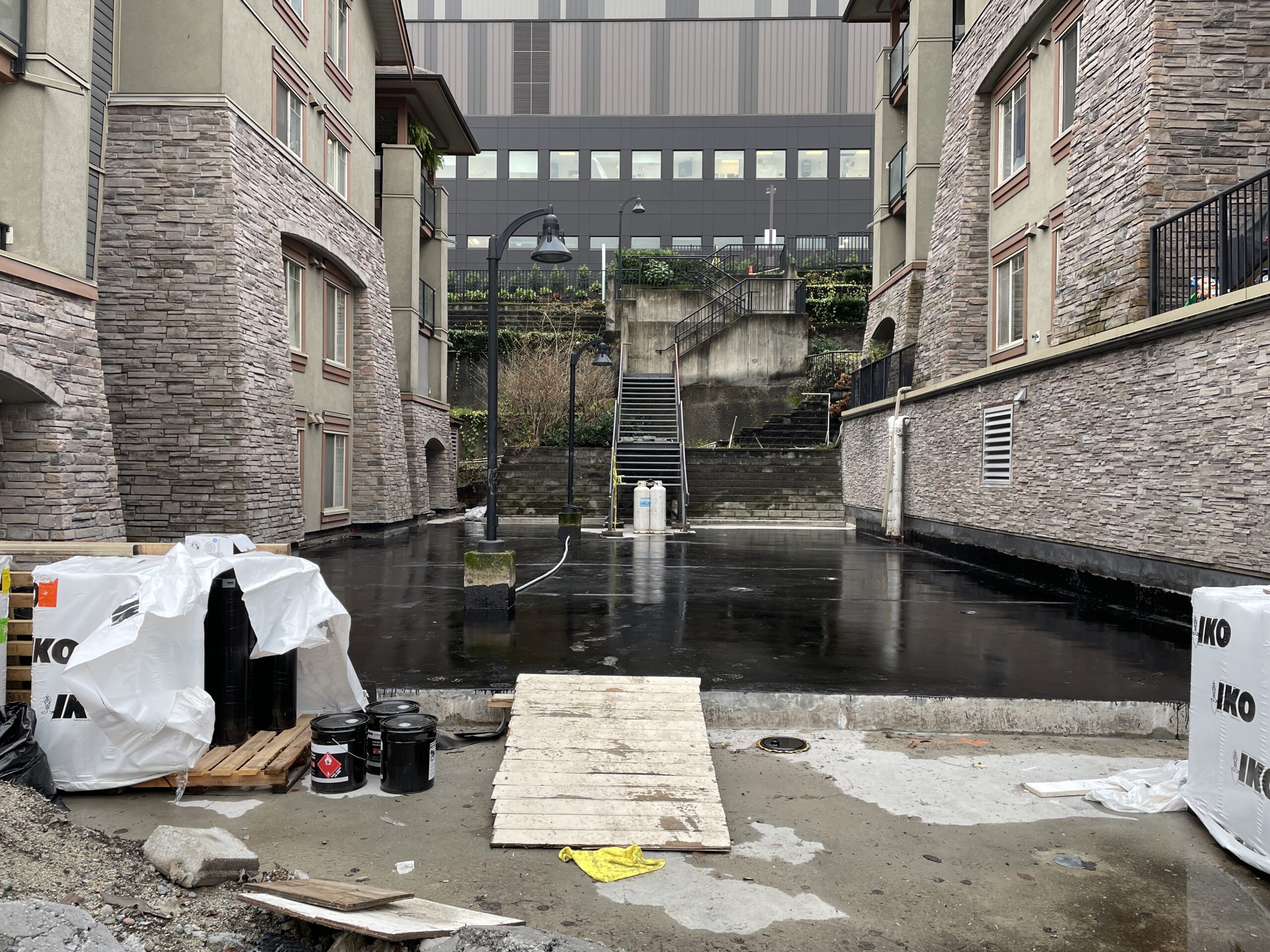

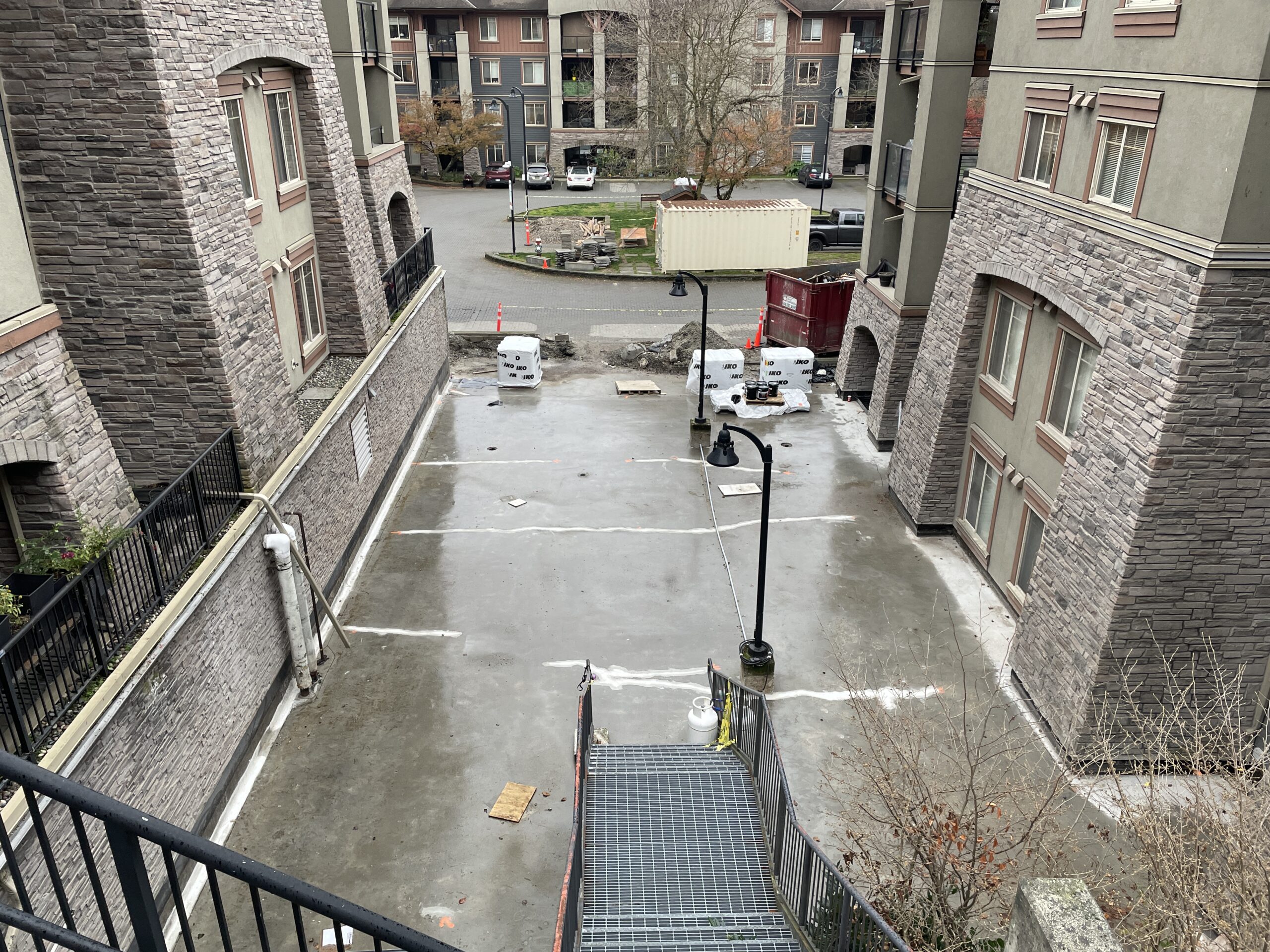

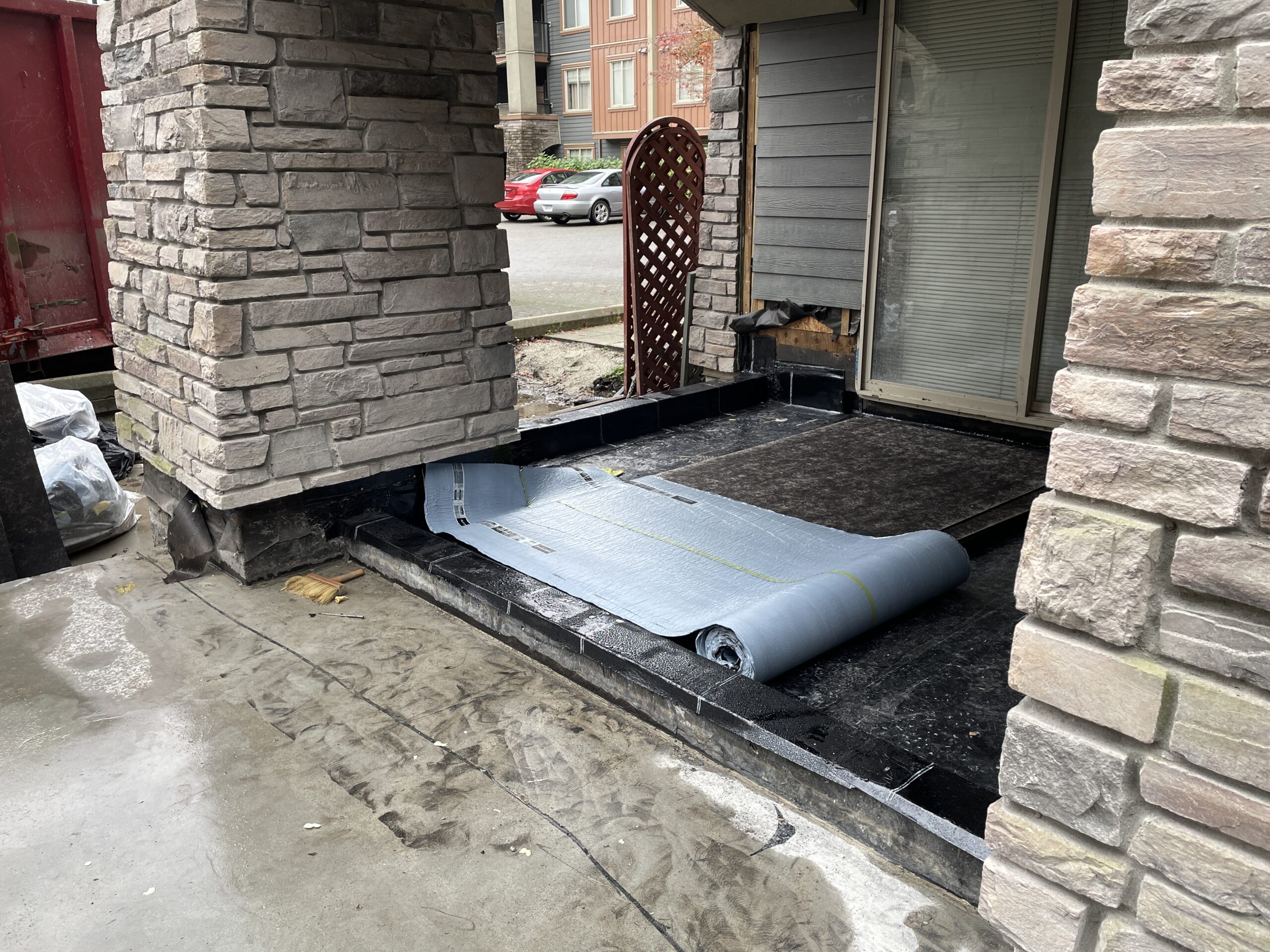

  • Continued work on installing membrane on the five affected patios.
  • Application of primary to the majority of the concrete slab between the 244 and 248 buildings.

Phase 1 Membrane Project, Day 65 (November 17, 2025)

Phase 1 Membrane Replacement Project

Project Mobilization Date: August 11, 2025
Work Start Date: August 28, 2025
Expected duration: 2–3 months (Completion now expected in January 2026)
Primary contractor: Prostar https://prostar.ca/

Weather: 11C, drizzle and light rain

No work onsite today.

Biweekly onsite meeting took place with:

  • Strata Engineering
  • Prostar
  • Copperstone Council, represented by the Vice President
  • Quay Pacific had no representation this week due to illness

Phase 1 Membrane Project, Day 63 (November 14, 2025)

Phase 1 Membrane Replacement Project

Project Mobilization Date: August 11, 2025
Work Start Date: August 28, 2025
Expected duration: 2–3 months (Completion now expected in January 2026)
Primary contractor: Prostar https://prostar.ca/

Weather: 9C, clouds and rain, at time heavy

Work done today:

  • Continued work on applying primer and laying down membrane on the five affected patios on Building 244.
  • Workers onsite: At least two.

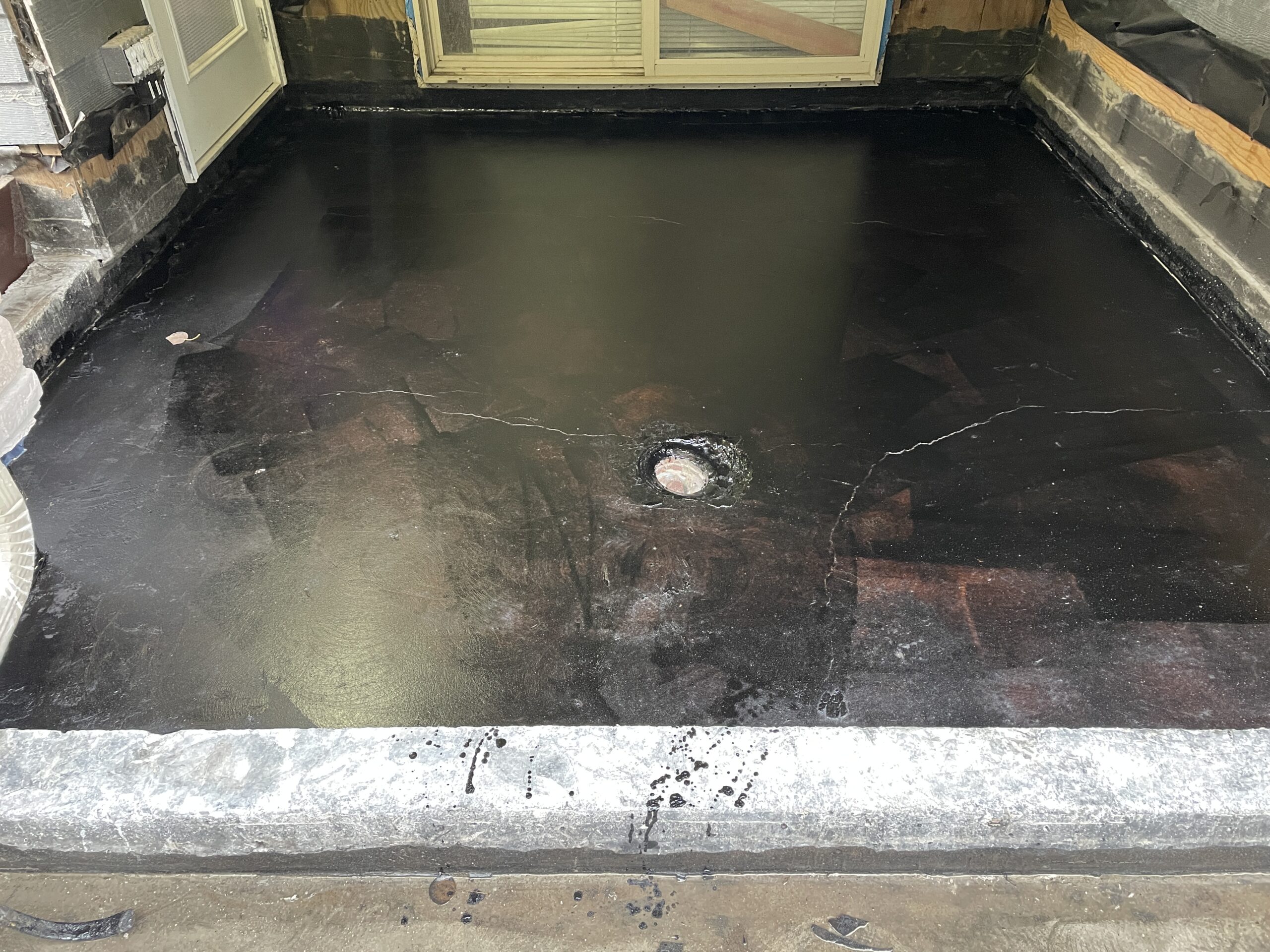

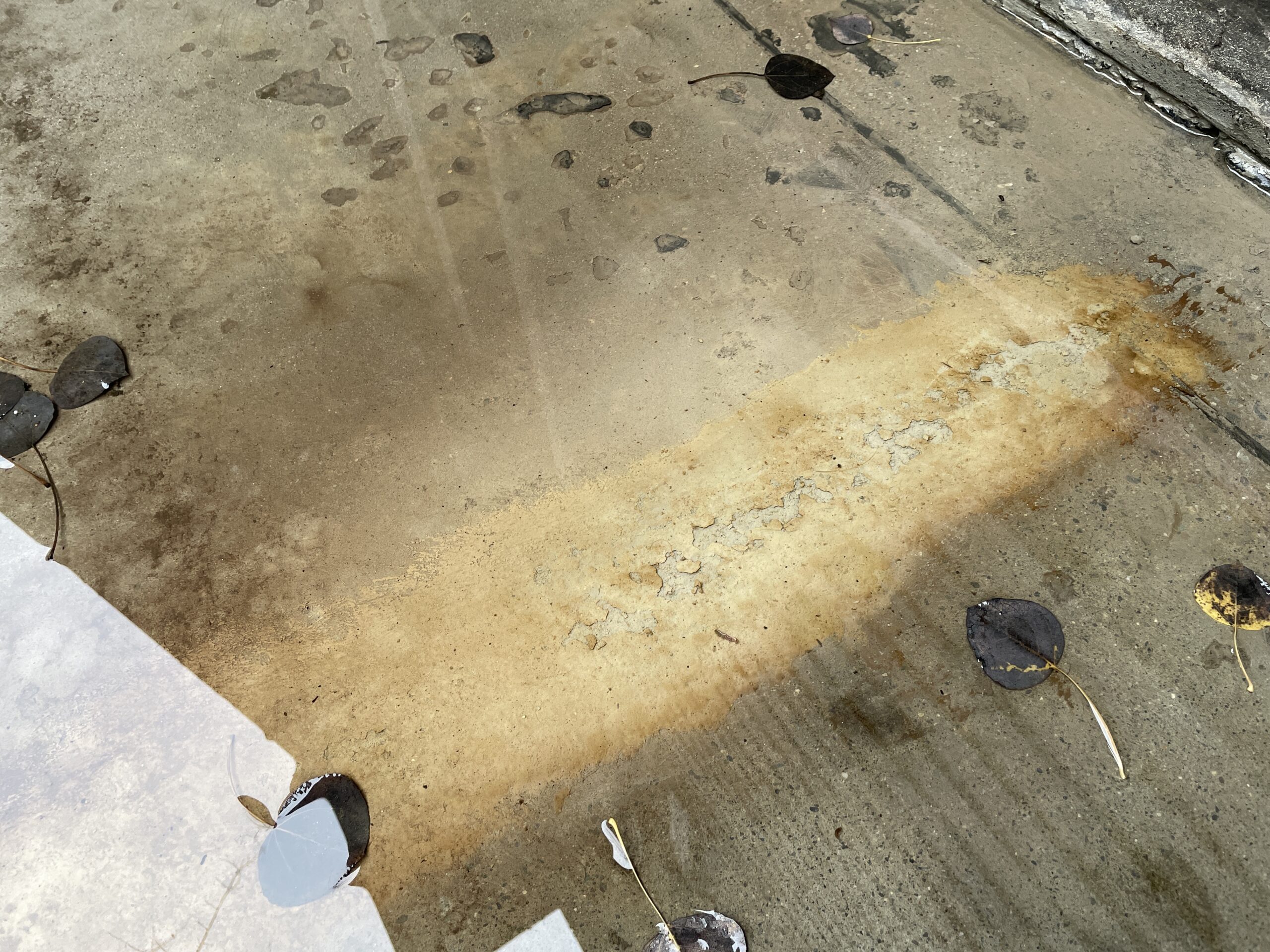

The following shot is of a crack repair behind the 244 building. While the concrete curb and other crack repairs were covered with plastic for several days after the work was done, this crack was left exposed. This shot, taken on November 14, shows how the crack is both partially submerged under standing water and how the Krten Krystol mixture is starting to flake off.

Phase 1 Membrane Project, Day 62 (November 13, 2025)

Phase 1 Membrane Replacement Project

Project Mobilization Date: August 11, 2025
Work Start Date: August 28, 2025
Expected duration: 2–3 months (Completion now expected in January 2026)
Primary contractor: Prostar https://prostar.ca/

Weather: 12C, Heavy rain at times, clouds

Work done today:

  • Work on the application of primer and membrane on patios has begun.
  • Workers onsite: At least three.
  • Strata Engineering also appeared to be onsite in the morning.
  • Other work may have been done, but I can’t confirm.

Phase 1 Membrane Project, Day 61 (November 12, 2025)

Phase 1 Membrane Replacement Project

Project Mobilization Date: August 11, 2025
Work Start Date: August 28, 2025
Expected duration: 2–3 months (Completion now expected in January 2026)
Primary contractor: Prostar https://prostar.ca/

Weather: 10C, clouds and showers

Work done today:

  • Additional repair work on leaks
  • Delivery of two large propane tanks
  • Delivery of at least five large cans of liquid material (possibly primer)
  • Workers on site: At least 3
