Weather: 15°C, showers and clouds
Workers onsite: At least 3
Work done today:

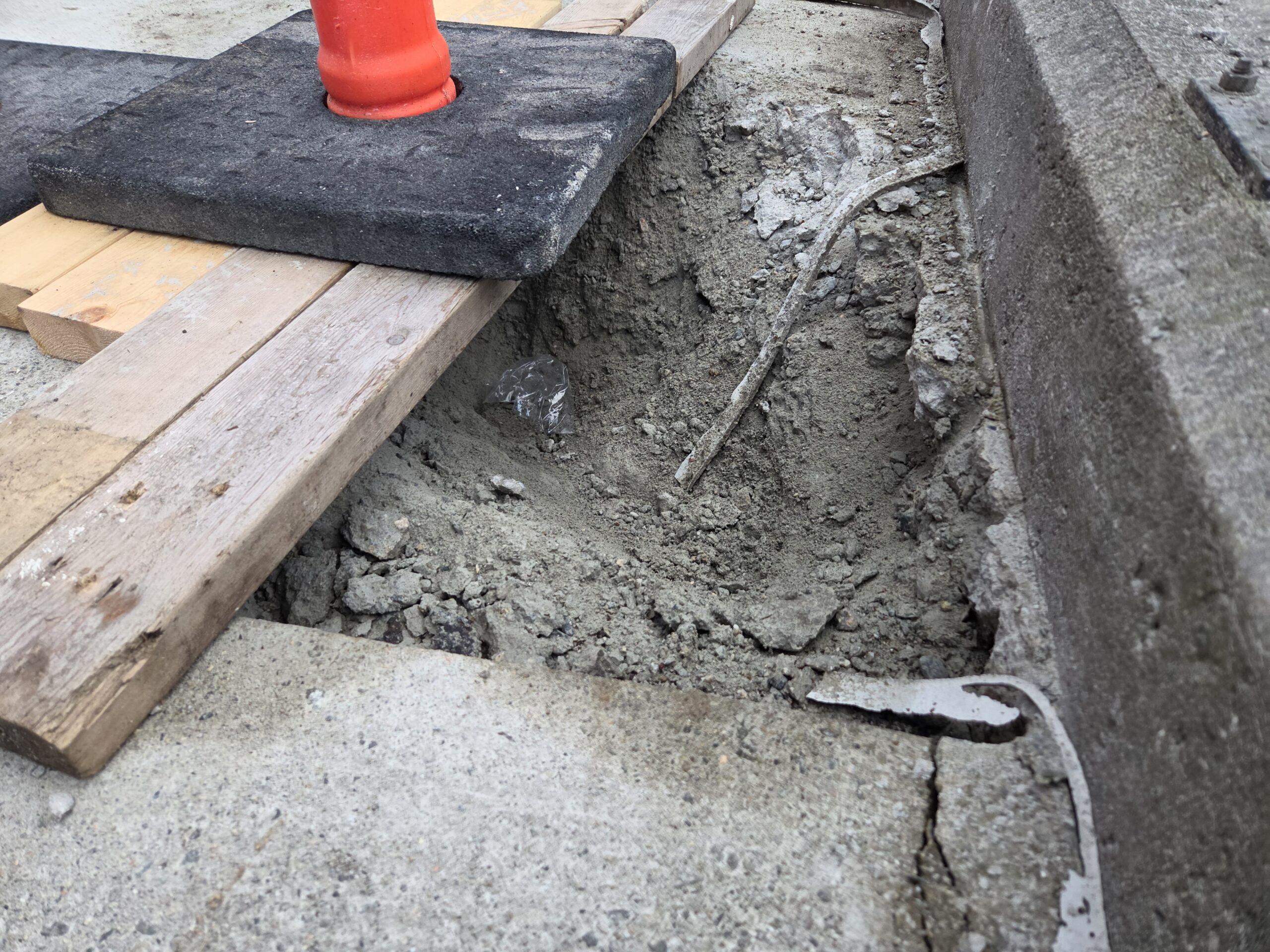

- Work began on the removal of the sidewalk section at the east end of the emergency repair area.

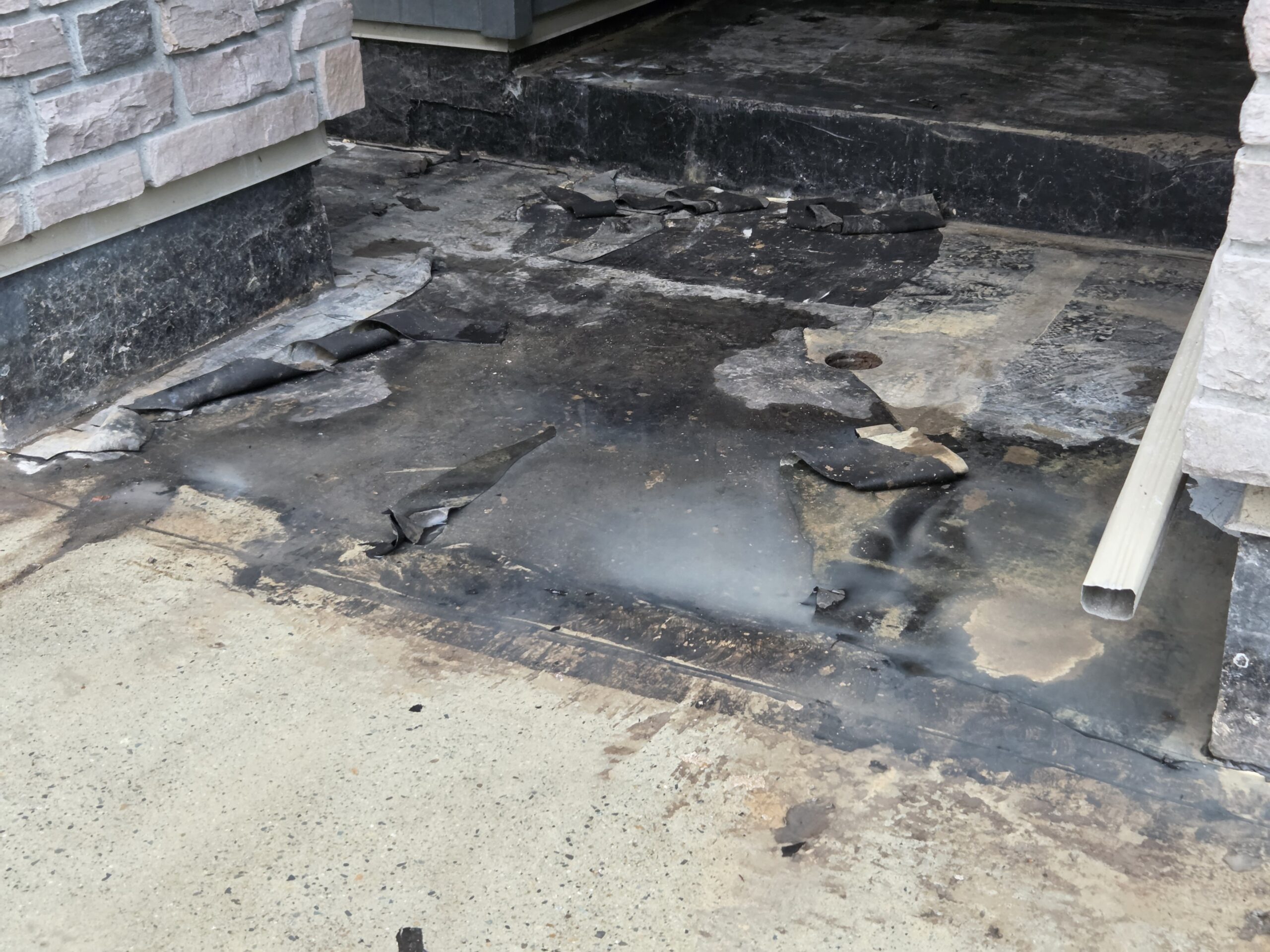

- Work was done to remove membrane on the patio closest to the 244 building main entrance.
The work on the sidewalk is to allow the new membrane to go underneath, creating a proper seal. This was not done in the original design.

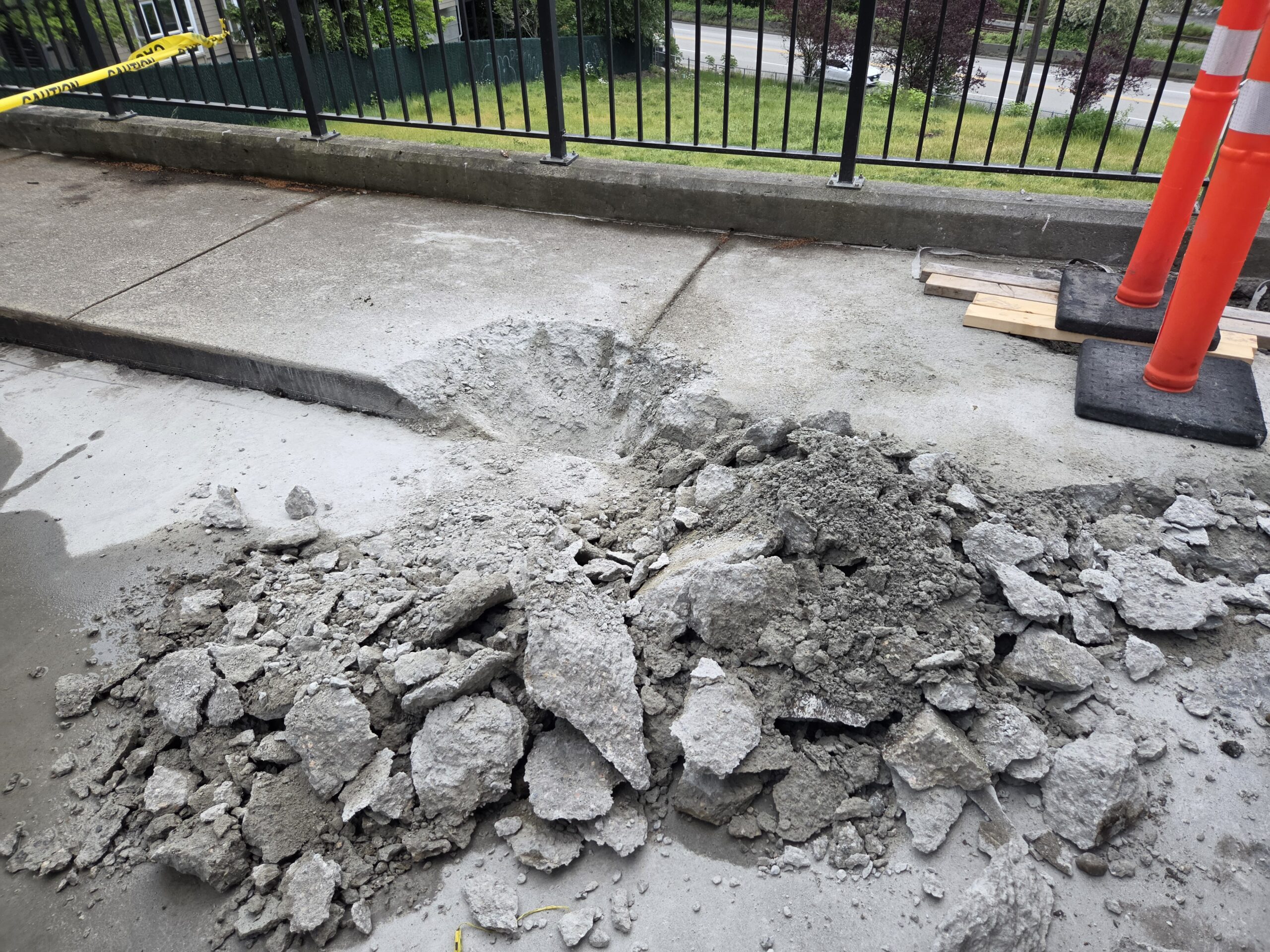

Despite working most of the day (and past the 6 p.m. cut-off), the small electric jackhammer used didn’t allow the workers to get much done, as seen below.


Work was also done to remove membrane from the below patio. For some reason, workers elected to use hand scrapers to manually pull the membrane off, rather than the more efficient machines on hand.
